Factual record. No finding of causation or responsibility is made here.

Bronagh’s road · Weather and works evidence · 5 September 2026

The bank before the turn: rain, records and work-site safety

The bank before the turn needs to be examined alongside the rain, the road surface, the open drainage and the protection provided to drivers—not as a separate detail.

Bronagh died at Killardry Bridge on 24 April 2025. The Garda release places the collision after 10pm. That is after 21:00 UTC: Ireland was on summer time. The station records below establish rainfall at the named gauges. They do not place a gauge on the bridge or show the exact surface under her tyres. [1]

What the nearby gauges actually recorded

Cahir (Toureen), approximately 1.1km from the bridge, recorded 21.5mm for the rainfall day labelled 24 April 2025. The Cahir Vocational School and Bansha gauges provide nearby comparisons, not measurements of the same patch of road. [2]

Daily station observations · 2025-04-24 rainfall-day label. 24 Apr 10:00–25 Apr 10:00 Irish local; 24 Apr 09:00–25 Apr 09:00 UTC.
StationApprox. kmRain (mm)
CAHIR (Toureen)1.121.5
CAHIR (Vocational School)5.614.3
BANSHA (Aherlow W.W.)10.222.0
The period matters. These daily readings cover 10am on 24 April to 10am on 25 April, Irish local time (09:00–09:00 UTC). They include hours after the collision. They are not totals “before Bronagh crashed”, midnight-to-midnight totals or hourly rainfall rates. Met Éireann assigns the following morning’s reading to the preceding day. [3]

Toureen also recorded rain on each of the four rainfall days labelled 20–23 April: 9.2, 1.1, 10.1 and 3.2mm respectively, totalling 23.6mm. That aggregate covers 10am on 20 April to 10am on 24 April locally. It provides antecedent weather context, not a measurement of saturation at the bank. [2]

What the hourly record says about the evening

The closest station found with an available hourly record for the period is Moore Park, approximately 34km away. Its hourly observations show rain around the time of the collision. This is regional timing evidence, not a claim that the same rate fell at Killardry. [4]

MOORE PARK · approximately 34.3 km · confirmed hourly intervals
Irish local intervalUTC endingRain (mm)
24 Apr 18:00–19:0024 Apr 18:000.2
24 Apr 19:00–20:0024 Apr 19:000.2
24 Apr 20:00–21:0024 Apr 20:000.3
24 Apr 21:00–22:0024 Apr 21:001.7
24 Apr 22:00–23:0024 Apr 22:001.8
24 Apr 23:00–25 Apr 00:0024 Apr 23:001.2
25 Apr 00:00–01:0025 Apr 00:000.7

The Moore Park row timestamped 21:00 UTC corresponds to 22:00 Irish local time and records 1.7mm for the preceding hour. The next records 1.8mm. The hour-ending interpretation was cross-checked against the same station’s published one-minute observations: 60 readings per hour reproduce each total shown. An hourly total still does not identify the minute-by-minute conditions at a site 34km away. [4]

This check does not establish “heavy rain at the bridge at 22:01”. The close daily gauge provides local-area accumulation; the more distant hourly station provides timing at its own location. Neither establishes the exact amount of rain that had fallen on the bank when Bronagh arrived.

The bank, the open drain and the bridge must be examined together

Mike identifies the worked stretch as continuing to the bridge on the right-hand side when approaching it in Bronagh’s direction of travel. His account is that this was an active council work site without barriers, working warning signs or illuminated cones. This is the family’s identification of the extent and condition of the works; the dated works and traffic-management records are needed to establish those arrangements for the night itself.

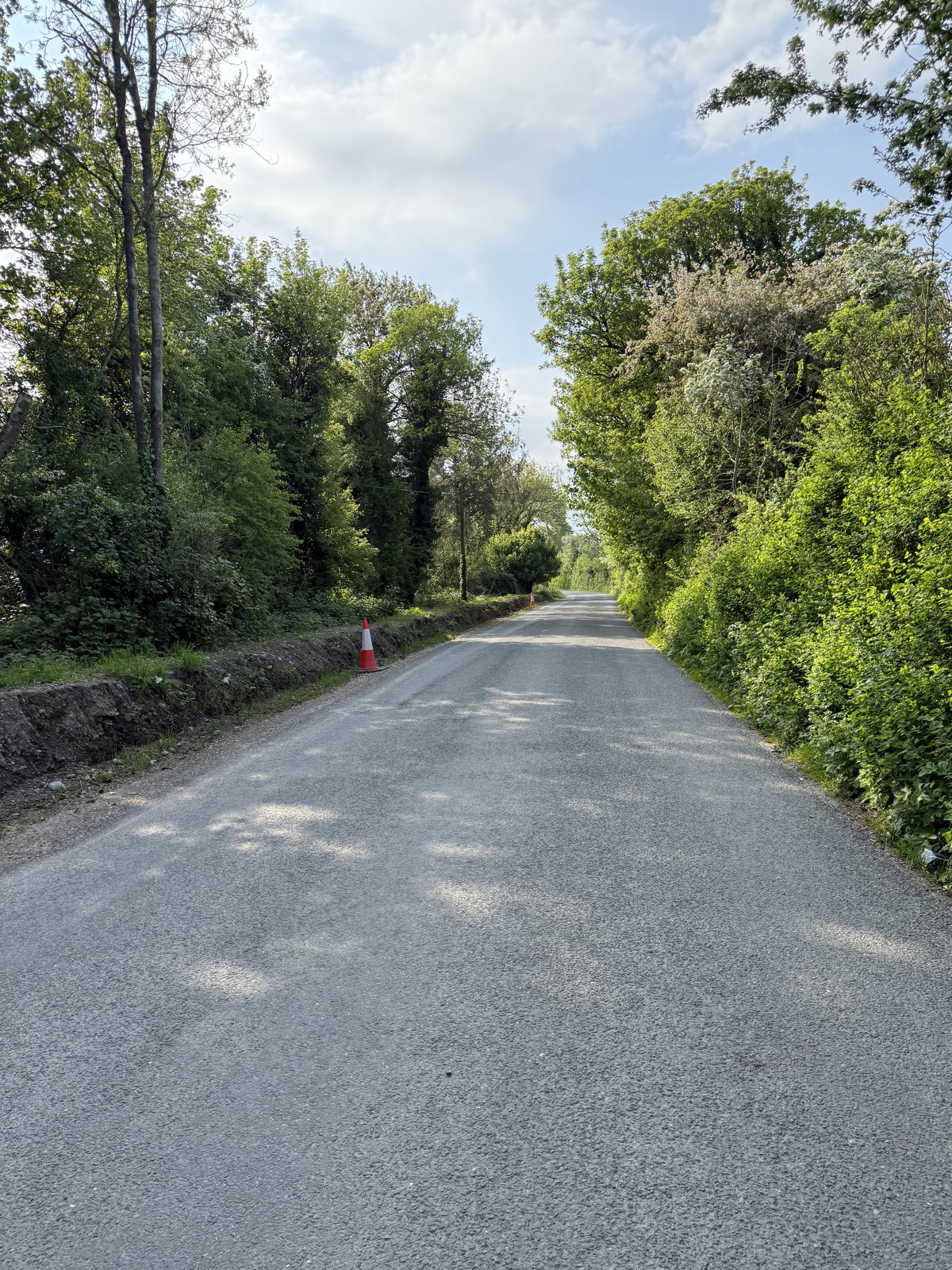

The family’s later photograph of exposed earth beside the road, with a channel at its base and cones along the margin
Family photograph, 1 May 2025—seven days after the collision. The exposed earth, roadside channel and cones are visible in this later view. Image-left and image-right depend on camera direction; Mike’s right-hand-side description refers to travel towards the bridge. This photograph does not establish the night’s signs, lighting or surface contamination.

The council’s written position must also be clear. Its internal review of 18 February 2026 describes roadside verge-inlet cleaning on the L3151, no specific drainage works on the bridge itself, and programmed 2025 roadworks northwest of the bridge. That answer does not settle the family’s question about the full photographed stretch, the date of each operation or the arrangement left overnight. A separate programme reference for the L31011-0 cul-de-sac must not be treated as proof of work on the bridge approach. [5]

Rain can detach exposed soil and runoff can transport it. If there was a connecting route to the carriageway, sediment delivery is a mechanism requiring investigation. But colour alone does not prove clay content, and later photographs do not establish a deposit in Bronagh’s wheel path. The detailed loose-soil-bank explainer sets out the process, controls and evidence needed.

The bank question sits alongside, rather than replacing, the existing engineering record on the bend, warnings and parapet. Denis Wood Associates’ report of 25 July 2025 considers wet-road bend conditions using assumed grip (p6), supports warning provision (p10) and discusses the damaged wall (p7). It expressly excludes investigation of incident causation (p2). It is not cited here as a finding that clay from this bank caused the collision. Read the existing engineering and bridge record.

What the council should have ensured at the works described

Road users need a safe route past works—including when the workforce has gone home. The proper test is not whether a few cones appear in a later photograph. It is whether the actual hazards were assessed, appropriate safeguards were in place, and those arrangements remained effective in darkness and changing weather. Irish guidance addresses those issues explicitly. [7]

Who carries the duty? Regulation 97 of the 2013 Construction Regulations applies to the contractor responsible where road construction work opens, excavates, breaks up or obstructs part of a road under its stated conditions. It requires appropriate guarding and lighting, necessary traffic signs, competent supervision and monitoring/corrective action. The council’s role—as client, contractor, road authority or a combination—must be established, not assumed. The statutory duty is distinct from the supporting guidance below. [6]

1. Assess the whole approach, not just the machine’s working position

The plan should identify the full affected stretch, how traffic passes it, and who coordinates the safeguards. HSA guidance addresses supervision across the full extent of works. For the stretch Mike identifies, the assessment needs to account for the right-hand bank and drainage continuing towards the bend and bridge—not stop at an arbitrary point before them. Request the dated plan and the responsible roles. [8]

2. Give useful warning before a driver reaches the hazard

HSA guidance calls for advance warning; Chapter 8 calls for a drive-through or visual check of the installed arrangement. The question is what a driver approaching this bend would actually see, and in time to do what. A permanent junction-control sign does not demonstrate that temporary roadworks warnings existed. Request the sign layout, placement dates and inspection record. [8] [9]

3. Assess the open drain and edge for real protection

An open channel beside traffic needs assessment of its position, depth and exposure. Regulation 97’s guarding duty is circumstance-dependent; Regulation 55 also addresses specified accessible excavations, with conditions and exceptions. Neither is a blanket rule that every roadside ditch must have the same barrier. [6]

Cones are not vehicle restraint. Chapter 8 distinguishes guidance/delineation barriers from systems designed to restrain an errant vehicle. Ask what protection was selected for the actual risk along this edge, including the transition towards the bridge, and why. [9]

4. Make the arrangement effective at night

Chapter 8 recommends amber steady lamps, or permitted lamp/rotating-reflector combinations, at intervals along cone lines in unlit areas; rotating reflectors are not permitted on lead-in tapers. This is not a requirement for a lamp on every cone. The relevant evidence is the lighting plan, ambient conditions and actual visibility and condition of the equipment left that evening. [9]

5. Respond to rain, mud and changing conditions

Chapter 8 addresses cleaning construction mud from road surfaces and warning equipment. Operations guidance recommends more frequent inspections in bad weather and highlights overnight and weekend checks. For this bank, ask how runoff and sediment were controlled, what checks occurred before the collision, and what cleaning or corrective action followed—not simply whether a drainage operation had been undertaken. [9] [7]

6. Leave an unattended site safe, not merely empty

The operations guidance calls for hazards to be removed or secured, the works area reduced and made stable, pedestrian exclusion, and continued maintenance of temporary traffic management at unattended works. It recommends recording or photographing the arrangement before leaving. The absence of workers is not the same as the absence of an unfinished hazard. Request the overnight arrangement for 24 April. [7]

7. Check the surface before removing the protection

Before temporary traffic management is removed, the guidance says construction should be complete and the surface suitable for the traffic using it. That makes the completion and reopening checks important: what remained beside the carriageway, was the route safe to use, and who checked? A programme entry or a statement that work had taken place is not that performance record. [7]

These are concrete safety questions, not a finding that a particular person committed an offence. The guidance identifies what an adequate arrangement should address. The works records and contemporaneous evidence must establish what applied here and what was actually provided.

The questions that need documentary answers

  • What was the precise extent of the works along the right-hand approach to the bridge, and on what dates was each part disturbed, drained, compacted or reinstated?
  • Who was responsible as client, contractor and traffic-management supervisor, and what site-specific assessment covered the bend, bank, open drainage and bridge edge?
  • What signs, guarding, lighting and overnight arrangements were actually installed before 22:00 on 24 April?
  • What inspections, rainfall-related checks, cleaning or corrective actions were recorded before the collision?
  • What contemporaneous evidence establishes whether water or sediment from the bank reached the traffic surface?

The case for examining this bank does not depend on pretending we witnessed the night. There are measurements to inspect, a recognised physical mechanism to assess, later photographs to locate and date, and work-site records that should explain the safety arrangements. Each has a different evidential role. Together they define the investigation needed; they do not, by themselves, determine causation or guilt.

Sources, data and method

  1. Garda collision appeal, issued 25 April 2025. Its headline identifies Thursday 24 April; the body contains a conflicting date. This analysis follows the headline and the date of that Thursday, not the body’s typographical error. No precise collision minute is asserted.
  2. Met Éireann historical daily files: Cahir (Toureen), station 9312; Cahir (Vocational School), 4612; Bansha (Aherlow W.W.), 5012. All displayed daily observations have rainfall indicator 0, satisfactory.
  3. Met Éireann: daily rainfall key and rainfall observation periods.
  4. Met Éireann: Moore Park hourly extract, station 575; April 2025 minute observations ZIP; hourly key. Displayed hourly rainfall indicators are 0, satisfactory. Gurteen was also checked as a farther comparison; Shannon’s differing indicator code was not treated as equivalent without a verified decode.
  5. Council internal review, 18 February 2026: existing public extract. Road-number distinction checked against the council’s separate 2026 FOI decision. No private correspondence or expert report is newly released with this article.
  1. S.I. 291/2013, Construction Regulations, Regulation 97, pp64–65; Regulation 55, p46. The amendment register and S.I. 129/2019, 102/2020 and 528/2021 were checked: those amendments do not change the cited regulations’ text. Duty-holder and application conditions remain important.
  2. Temporary Traffic Management Operations Guidance, Part 0, first edition August 2019: §§0.2.3.2, 0.3.2.6, 0.3.6.2 and 0.3.6.5 (pp0-32, 0-47, 0-54, 0-56). Operational guidance; recommendations are not automatically standalone statutory offences.
  3. HSA, Guidelines for Working on Roads, updated November 2014, pp10–11 and 14: warning, coordination and continued checks.
  4. Traffic Signs Manual, Chapter 8, August 2019: §§8.1.8.5, 8.1.9.1, 8.3.8.3–7 and 8.3.9 (pp8/10–11, 8/61–63). The source distinguishes requirements, recommendations and options. The 2025 upload directories are not the edition dates; the Department’s manual page, updated 12 February 2025, also identifies the supporting Chapter 8 guidance.

Station selection: the official Met Éireann station catalogue was checked for nearby stations with records covering April 2025. Closed stations were not substituted. Distances are approximate straight-line distances from the NIAH bridge location, record 22207506, using the published Irish Grid coordinates converted to WGS84 and the coordinates in each weather file. They are not driving distances or an assessment of meteorological representativeness.

Download the displayed observations (CSV) · Calculation method and displayed data (JSON). Retrieved 5 September 2026. UTC converted using Europe/Dublin; original dates, indicators and source files are retained. The antecedent total and distances are this site’s calculations.

Weather data: Copyright Met Éireann. Source: www.met.ie. This data is published under a Creative Commons Attribution 4.0 International (CC BY 4.0) licence. Met Éireann does not accept any liability whatsoever for any error or omission in the data, their availability, or for any loss or damage arising from their use. See Met Éireann open-data terms. This material has been modified through extraction, aggregation, presentation and local-time conversion by the Bronagh English record. It is not an endorsement or site-specific report by Met Éireann.

This is a public evidence analysis, not a forensic reconstruction, legal determination or finding of fault. The physical mechanisms, measured weather, family account and unresolved site-specific questions are distinguished throughout.

Cahir–Cashel road statistics Cahir–Cashel Deadly place to drive ↗ × Cahir–Cashel road statistics Road statistics · sourced comparison Cahir–Cashel: 3.03× the national road-death rate 1 January 2018–31 December 2023 (six complete calendar years) . In the full Tipperary–Cahir–Cashel Municipal District, including its rural areas, the derived annualized rate was 8.61 people killed per 100,000 residents , compared with 2.84 nationally . This is an area comparison relative to population, not a personal likelihood. This page uses the full municipal district, not the populations of Cahir and Cashel towns. The linked road-deaths map and record has broader coverage and a different purpose. The headline figures 23 people killed in 21 fatal-collision records in the district 8.61 annualized people killed per 100,000 residents 3.03× the State rate on this population basis 36.5% of County Tipperary’s deaths and 26.5% of its population; the district rate was 37.6% above the county rate. District results The district’s fixed Census 2022 population is 44,532 . The 23 people comprised 11 drivers, 5 passengers, 5 pedestrians, 2 motorcyclists . They were not all drivers. Annual district deaths were 6, 4, 1, 3, 3, 6 from 2018 to 2023. Scroll horizontally to read this table. Five Tipperary municipal districts District 2022 population Fatal-collision records People killed People killed per 100,000 per year Clonmel 25,003 10 13 8.67 Tipperary–Cahir–Cashel 44,532 21 23 8.61 Carrick-on-Suir 20,191 7 7 5.78 Nenagh 40,879 11 12 4.89 Thurles 37,290 8 8 3.58 Scroll horizontally to read this table. Annual people killed Year Tipperary–Cahir–Cashel County Tipperary State 2018 6 10 134 2019 4 13 140 2020 1 7 141 2021 3 10 132 2022 3 7 152 2023 6 16 179 County comparison National baseline: the Republic of Ireland recorded 878 people killed across a fixed Census 2022 population of 5,149,139 , an annualized rate of 2.84 per 100,000 residents over these six years. Tipperary recorded 63 people killed , a rate of 6.25 , ranking #2 of 26 counties behind Monaghan (6.38). Tipperary’s rate was 2.20 times the national rate. Scroll horizontally to read this table. All 26 counties, ranked by annualized rate; the CSO county aggregate does not supply mapped source-record counts Rank County 2022 population People killed Fatal-collision records People killed per 100,000 per year 1 Monaghan 65,288 25 — 6.38 2 Tipperary 167,895 63 — 6.25 3 Donegal 167,084 53 — 5.29 4 Roscommon 70,259 22 — 5.22 5 Louth 139,703 41 — 4.89 6 Cavan 81,704 23 — 4.69 7 Mayo 137,970 38 — 4.59 8 Offaly 83,150 22 — 4.41 9 Kerry 156,458 41 — 4.37 10 Kilkenny 104,160 27 — 4.32 11 Leitrim 35,199 9 — 4.26 12 Longford 46,751 11 — 3.92 13 Westmeath 96,221 22 — 3.81 14 Clare 127,938 29 — 3.78 15 Meath 220,826 49 — 3.70 16 Sligo 70,198 15 — 3.56 17 Limerick 209,536 44 — 3.50 18 Wexford 163,919 34 — 3.46 19 Galway 277,737 49 — 2.94 20 Carlow 61,968 9 — 2.42 21 Cork 584,156 83 — 2.37 22 Laois 91,877 12 — 2.18 23 Waterford 127,363 15 — 1.96 24 Wicklow 155,851 18 — 1.92 25 Kildare 247,774 25 — 1.68 26 Dublin 1,458,154 99 — 1.13 A higher district comparator Boyle Municipal District, County Roscommon, recorded 15 people killed in 14 source records from a population of 24,421: 10.24 per 100,000 , about 19% higher than Tipperary–Cahir–Cashel. This is not a claim that Boyle is Ireland’s worst district; 11 districts were screened in this targeted comparison. Clonmel’s 8.67 rate is marginally higher than Cahir–Cashel’s 8.61; the largest raw count is not the highest district rate. Public council minutes: 2024–2026 These later public records are separate from the 2018–2023 statistical comparison. They record requests, responses and planned work—not findings of causation or proof that work was completed. 2025-05-26 James Swords: recorded response to a safety request The minutes record Councillor John O’Heney asking for safety measures following a recent tragic incident. James Swords is listed as District Engineer present; the response is attributed to that role. Limit: The minute does not name the bridge or specify a parapet repair. It does not say that Gardaí were to design or direct a bridge repair. there is an ongoing Gardai investigation into the incident and if there are any recommendations from the report it will be implemented. Excerpt from the minutes, not a verbatim speech transcript. Official minutes — attendance and District Engineer, PDF p. 1 — Officials Present; James Swords, District Engineer Official minutes — District Engineer’s report, PDF p. 5 — Item 3.4, District Engineer’s Report Official minutes — recorded response, PDF p. 6 — Item 3.4, District Engineer’s Report 2024-10-14 Máirín McGrath seconded the default-speed-limit motion Motion 2861 was proposed by Cllr Niall Dennehy and seconded by Cllr Máirín McGrath, a Cahir LEA member. The full County Council recorded unanimous agreement. The motion sought selective application of the new default limits, rather than universal application across the county. Limit: This was not a motion introducing a blanket 80-to-60 reduction. The December clarification below records the legal-advice referral. Official October minutes — Motion 2861, PDF p. 12 — Item 8.2, Notice of Motion Ref. 2861 Official October minutes — unanimous outcome, PDF p. 15 — Notice of Motion Ref. 2861 outcome Official Council AGM minutes — elected-area roles, PDF p. 2 — Item 2.1, elected members by electoral area 2024-12-09 Council clarification and legal advice The minutes record Chief Executive Sinéad Carr acknowledging support for Motion 2861, while explaining that legal advice was being sought on whether a plenary motion could supersede national legislation. The October minutes were to be amended to reflect that clarification. Limit: This does not establish a road-specific exception or a suspension of national rules. Official December minutes — clarification, PDF p. 2 — Item 3.1, Matters Arising on October minutes 2025-01-13 80-to-60 implementation and weather-delayed signs The minutes record 7 February 2025 as the commencement date for the rural-local-road default reduction from 80 to 60 km/h. They also record severe weather delaying sign-installation work and distinguish a later, wider Phase 2 review. Limit: This is a dated implementation note, not proof of the limit or weather at any individual crash site. Official January minutes — Speed Limit Review, PDF p. 11 — Item 7.1, Roads, Transportation, Health & Safety 2026-05-25 477 district bridges; 14 applications; three funded The District Engineer reported €1 million in county bridge funding, 477 bridges in the district, applications for 14 bridges requiring work and funding for three. Limit: The minute does not establish whether Killardry was among the 14; funding is not proof of completed work. Official May 2026 minutes — bridge funding, PDF p. 6 — Item 3.6, District Engineer’s Report 2026-05-25 Temporary measures considered at Rehill Bridge Following Cllr Máirín McGrath’s request for urgent rehabilitation, the District Engineer reported that Rehill tender documents were nearly complete and temporary measures were being considered to reopen the bridge, with completion hoped for by the end of that week. Limit: This records a plan and expectation, not verified completion. Official May 2026 minutes — Rehill Bridge, PDF p. 6 — Item 3.6, District Engineer’s Report The earlier bridge inspection The family’s published summary of Council inspection record TY-L3151-B-010 reports “Significant Damage” on 21 January 2025 and records downstream capping as “partly removed”. That inspection predates both the 24 April 2025 collision and the 26 May 2025 meeting response. Limit: This is a summary of a Council record held on file, not the original report online. The records checked do not establish whether or when James Swords personally received or read the inspection report. Published family summary of the Council inspection record When was the inspection circulated to the district engineering team, and what action was recorded? Further accountability research Read the full sourced record on the primary statistics page . Representatives Engineering Payments Road budgets Crash coverage Weather Surfaces and works Exposure comparisons Method and limits People killed ÷ fixed 2022 population ÷ 6 years × 100,000. Populations are fixed Census 2022 references. Counts concern collision locations, not resident addresses; the result is not a rate per journey or vehicle-kilometre. Current 2024 reference boundaries are applied retrospectively. The series is provisional and subject to revision. The figures do not establish why crashes happened or measure road-maintenance spending. Return home · Open the broader road-deaths map and record Sources RSA SourceData — Map of Collisions source data — Fatal-collision source records, 2018–2023; mapped locations assigned to current reference districts. CSO ROA15 — Persons Killed and Injured — State and county people-killed totals, 2018–2023; provisional/revisable series. CSO ROA12 — All road users — Independent national cross-check of people-killed totals, 2018–2023. CSO Census 2022 Table 8.1 background notes — State and county 2022 population background. CSO FY108 — official statutory LEA population CSV — 2022 population basis and statutory LEA/district mapping. Tipperary County Council Adopted Budget 2024, Table 7 (PDF) — Five municipal-district populations labelled as based on Census 2022; physical page 20. Tailte Éireann 2024 statutory boundary dataset service — Checked 2024 Tailte Éireann statutory municipal-district boundary dataset service; current reference boundaries applied retrospectively. Irish Statute Book S.I. 631/2018 — Optional Boyle municipal-district/LEA mapping context. Download the five-district CSV · Download the 26-county CSV · Download the public JSON snapshot Factual record. No finding of causation or responsibility is made here.

Contact the family

If you have information about this road, this bridge, or the records on this site, you can write to Bronagh's family here.

Sent only to the family. Not shared, not stored by any third party.

Explore the record
